Skip to content

Delay Task

Overview

The Delay Task pauses workflow execution for a specified period. Use it to create timed sequences, respect rate limits, schedule actions, or wait for external processes to complete.

When to use this task:

  • Create follow-up email sequences (wait 3 days, send email)
  • Respect API rate limits between calls
  • Wait for external processes to complete
  • Schedule actions for specific times
  • Space out notifications to avoid overwhelming users
  • Create drip campaigns

Key Features:

  • Simple time delays (seconds, minutes, hours, days)
  • Wait until specific date/time
  • Dynamic delays using variables
  • Resume from exact delay point if workflow paused
  • Accurate to the second

Quick Start

Builder fields

The Field column is the label as it appears in the task builder; Key is the name the value is stored under and referenced by.

Field Key Type Default Notes

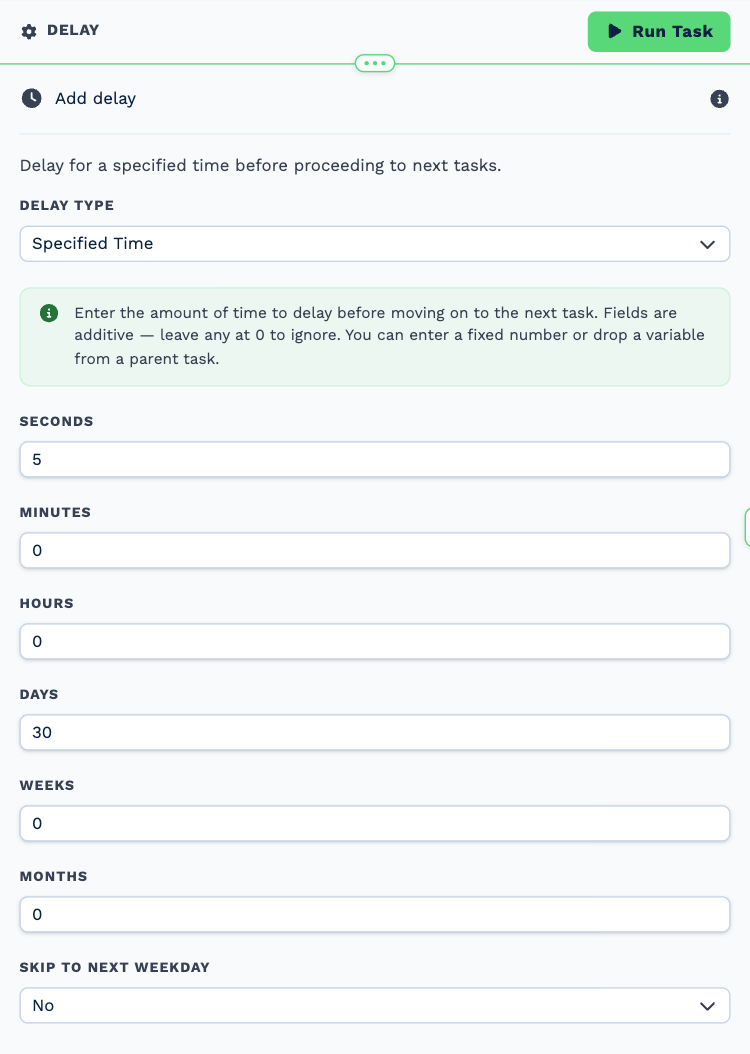

Delay Type delay_type select specified_time Options: Specified Time · Specify Date · Specify Date & Time
Seconds Seconds text – Only shown when delay_type is specified_time
Minutes Minutes text – Only shown when delay_type is specified_time
Hours Hours text – Only shown when delay_type is specified_time
Days Days text – Only shown when delay_type is specified_time
Weeks Weeks text – Only shown when delay_type is specified_time
Months Months text – Only shown when delay_type is specified_time
Date Date text –
Time (UTC) Date_time time –
Skip to Next Weekday next_weekday select no Options: No · Yes
  1. Add Delay task to workflow
  2. Select delay type (Duration or Until Specific Time)
  3. Enter delay amount or target date/time
  4. Save

Simple Examples:

Wait 5 minutes
Wait 3 days
Wait until 2024-12-25 09:00:00

Delay Types

Delay by Duration

Wait for a specific amount of time from now.

Configuration:

Delay Type: Duration
Amount: 3
Unit: Days

Units Available:

  • Seconds
  • Minutes
  • Hours
  • Days
  • Weeks

Examples:

5 seconds - Quick pause between API calls
10 minutes - Short wait for data processing
2 hours - Mid-day pause
3 days - Multi-day email sequence
1 week - Weekly follow-up

Wait Until Specific Date/Time

Pause until a precise future moment.

Configuration:

Delay Type: Until Date/Time
Date/Time: 2024-12-25 09:00:00
Timezone: Africa/Johannesburg

Use cases:

  • Send email at exactly 9 AM
  • Trigger action on specific date
  • Schedule end-of-month processing
  • Holiday campaigns

Format: YYYY-MM-DD HH:MM:SS

Examples:

2024-12-25 09:00:00 - Christmas morning 9 AM
2024-06-30 23:59:59 - End of financial half-year
2024-02-14 08:00:00 - Valentine's Day morning

Dynamic Delays

Use variables to set delay duration:

From another task:

Amount: {{task_42001_calculated_delay}}
Unit: Hours

From contact data:

Until Date/Time: {{task_15001_custom_follow_up_date}}

From trigger data:

Amount: {{task_47001_custom_delay_days}}
Unit: Days

Real-World Examples

Wait before following up

Form Submission
  └─ Email    send the welcome message
      └─ Delay   3 days
          └─ Email   "Did you get everything you needed?"

Pause until a specific date

CRM Trigger
  └─ Delay    until the renewal date on the client record
      └─ SMS  send the renewal reminder

{{task_7001_date_trigger}} reports exactly when the workflow will resume, which is the field to check if a delay does not fire when you expected.

A delay inside a loop holds the whole loop open

Everything beneath the loop has to finish before its done branch runs, so a long delay in the body postpones the summary by the same amount. See Loop.

Outputs

Field Type Example Notes
date_trigger string 2026-09-10 09:00:00 When the workflow will resume. The computed release time, UTC.
weekend string moved to Monday Present when the release time fell on a weekend and the next-weekday setting shifted it.
run boolean true false when the delay could not be calculated.
run_text string Delay set until 2026-09-10 09:00:00

The delay reports its release time, not its progress

There is no delay_started, delay_ends, delay_duration or completed field. date_trigger is the single value that tells you when the workflow continues.

Best Practices

Email Sequences

  1. Natural timing - 3, 5, 7 days feels more human than 2, 4, 6
  2. Avoid weekends - Use Date Formatter to check day of week
  3. Respect time zones - Send at appropriate local times
  4. Give opt-out - Include unsubscribe before long sequences

API Integrations

  1. Check rate limits - Read API docs carefully
  2. Add buffer - If limit is 60/min, use 1.1 second delays (safer)
  3. Exponential backoff - For retries, double delay each attempt
  4. Batch when possible - Prefer batch APIs over many individual calls with delays

Performance

  1. Short delays - Use seconds/minutes for immediate workflows
  2. Long delays - Days/weeks for nurture campaigns
  3. Avoid excessive delays - Don't wait months (use scheduled triggers instead)
  4. Resource usage - Delays keep workflows "running" but use minimal resources

Testing

  1. Test mode - Use shorter delays in test workflows (5 seconds vs 3 days)
  2. Skip delays - Use workflow "Fast Forward" feature for testing
  3. Check execution history - Verify delay started and ended correctly

Troubleshooting

Workflow Stuck in Delay

Check:

  • View execution history
  • Look for "Delay started at X, ends at Y"
  • If delayed for appropriate time, this is normal behavior

Expected: Workflow shows as "Running" during delay period.

Delay Not Respecting Timezone

Ensure:

✓ Correct: Until Date/Time with timezone specified
✗ Wrong: Until Date/Time assuming UTC

Example:
Date/Time: 2024-12-25 09:00:00
Timezone: Africa/Johannesburg

Delay Too Short or Too Long

Check units:

✗ Wrong: 3 Seconds (meant 3 Days)
✓ Correct: 3 Days

Verify value:

✗ Wrong: 1440 Minutes (24 hours in minutes)
✓ Correct: 1 Day (simpler)

Dynamic Delay Not Working

Ensure variable contains number:

{{task_42001_delay}} must return: 5
Not: "5 days" or "five"

Use numeric value only.

Frequently Asked Questions

Does the delay continue if I disable the workflow?

No. Disabling a workflow cancels active executions including delays.

What happens if I edit a running workflow with delays?

Changes apply to new executions only. Running delays continue with old configuration.

Can I have multiple delays in one workflow?

Yes, as many as needed:

Email → Delay 1 day → Email → Delay 3 days → Email

What's the maximum delay?

Practically unlimited, but:

  • Recommended max: 30 days
  • Use scheduled triggers instead for longer periods

Can I cancel a delay?

No, but you can:

  1. Disable workflow (stops future executions)
  2. Use workflow "Stop Execution" to cancel specific run

Does delay affect workflow execution limits?

No. Delayed workflows count as 1 execution, regardless of delay length.

Can I delay until a dynamic date?

Yes:

Until Date/Time: {{task_15001_custom_follow_up_date}}

Ensure date format is: YYYY-MM-DD HH:MM:SS

What if delay end time is in the past?

If "Until Date/Time" is past when task executes, workflow continues immediately (no delay).

How accurate are delays?

Very accurate:

  • Seconds: ±1 second
  • Minutes: ±5 seconds
  • Hours/Days: Within 1 minute

  • Timer Trigger - For recurring delays/scheduling
  • Date Formatter - Calculate future dates
  • If Task - Conditional delays
  • Loop Task - Delays within loops
  • Email Task - Most common task after delays
